Daily reports on
conduit drilling operation
Daily
report of drilling depth since Jan.10, 2003 CLICK!
Air hammer drilling down to 50 m was
followed by rotary drilling in mid-February.
Rig-site preparation before air-hammer
drilling and rig-up and istallation of water pipe lines had finished
by the end of 2002 (paved access
road and rig site with
pools in late November).
Explanation: To reach the drilling site, USDP-4 site (new RS-3),
construction of new forest road of about 400 m long is needed as the
extension of the existing forest road together with widening and
repairing of the latter. Drilling of wells of water that is essential
for conduit drilling had been carried out in the entrance of the
existing road. Installation of water pipe lines is also needed to the
USDP-4 site.
(Report from Tohoku Geothermal Energy
Co.Ltd)
Work of 8th week (September 8 to
15, 2002)
- New road construction (cutting/mounding,
and mud transportation)
- Widening and repairing of existing road
(cutting and guttering)
- Water well drilling (well #1: 80 m deep
and well #2: 49 m deep; without available water levels)
Work of 7th week (September 1 to 7,
2002)
- New road construction
- Widening and repairing of existing road
(measuring, cutting, leaving tree roots, crushing blocks)
- Water well drilling (well #1: 39 m deep
and well #2: 4 m deep)

[image of water well
drilling]
Work of 6th week (August 26 to 31,
2002)
- Construction of new road (cutting and
mounding)
- Widening and repairing of existing road
(measuring, cutting/mounding and removing tree roots)
- Water well drilling (installation of
drilling instrument and drilling down to 6 m)

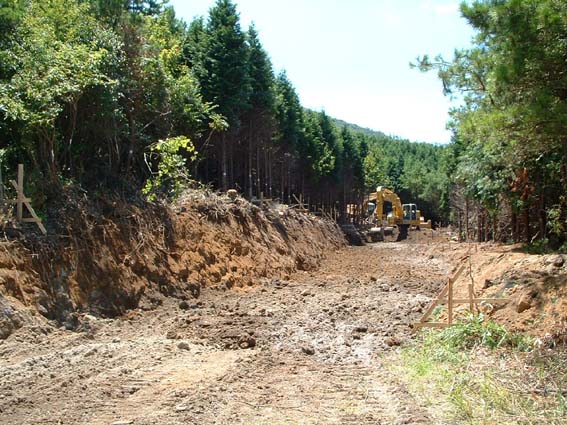

[Image of USDP-4 site]
[Image of water well
site]
Work of 5th week (August 19 to
24)
- Construction of new road
- Widening and repairing of existing road
(measuring and cutting/mounding)

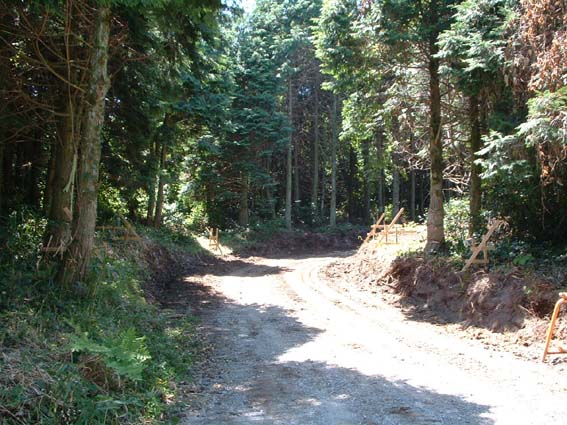

[Image of existing road]
[Image of new
road]
Work of 3rd and 4th weeks (August 5
to 18)
- Construction of new road
(measuring)
- Widening and repairing of existing road
(treatment of trees cut, resetting of geophone cables, and
measuring)

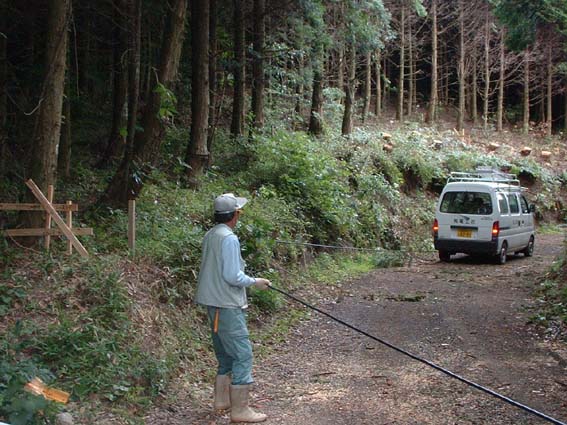

[Image of resetting of geophone
cable]
Work of 1st and 2nd weeks (July 27 to
August 3)
- Construction of new road (cutting trees
and the treatment)
- Widening and repairing of existing road
(cutting a part of trees and the treatment, removal of geophone
cables)

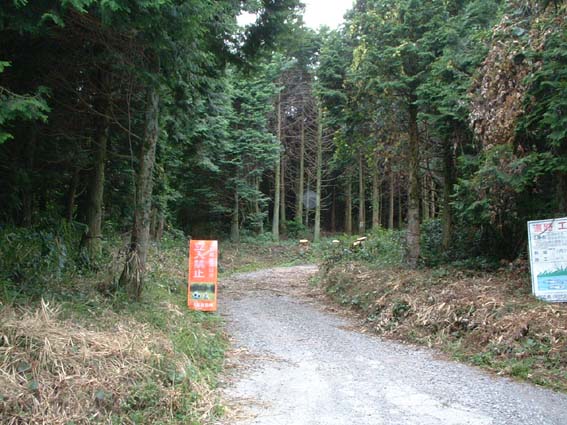

[Image of existing road]

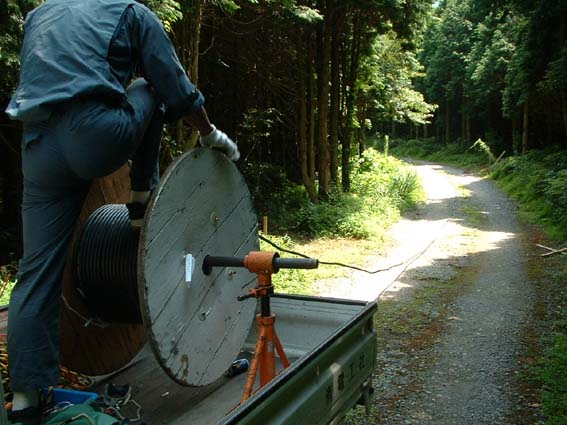

[Image of removal of
geophone cable]
